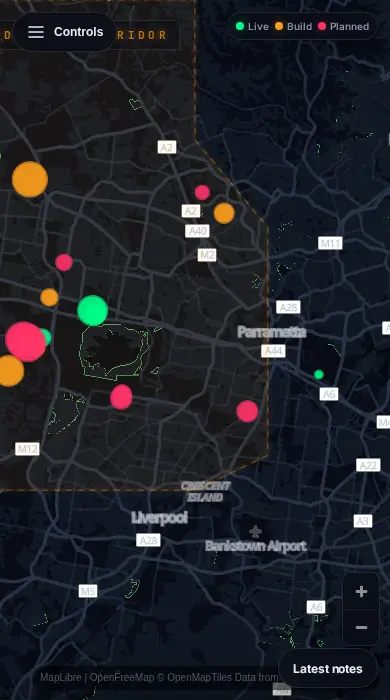

Sydney Data Centres Map
57 facilities and 15 substations: 30 operational, 8 under construction, 19 planned. Data checked 2 November 2026, updated 20 November 2026.
Cite this map: Certified Strategic, “Sydney Data Centres Map”, 17 April 2026, updated 27 November 2026. certifiedstrategic.com/maps/sydney
All Sydney data centres tracked
The facilities on the map above, as a list. Operator names link through to their Certified Strategic profile, or to their listing in the directory.
| Facility | Operator, suburb | MW, status |
|---|---|---|
| AirTrunk SYD3 | AirTrunk Huntingwood | 400 MW Total campus capacity, measure not stated Operational |
| AirTrunk SYD1 | AirTrunk Huntingwood | 130 MW Total campus capacity, measure not stated Operational |
| AirTrunk SYD2 | AirTrunk Lane Cove West | 120 MW Total campus capacity, measure not stated Operational |
| NEXTDC S3/S6 | NEXTDC Artarmon | 93.5 MW Operational |
| NEXTDC S2 | NEXTDC Macquarie Park | 30 MW Operational |
| Digital Realty SYD10/SYD11 | Digital Realty Erskine Park | 25 MW Operational |
| Telstra InfraCo St Leonards | Telstra InfraCo St Leonards | 20 MW Operational |
| Macquarie DC IC2/IC3 | Macquarie Data Centres Macquarie Park | 18 MW Operational |
| NEXTDC S1 | NEXTDC Macquarie Park | 16 MW Operational |
| GreenSquareDC SYD1 | GreenSquareDC Norwest | 15 MW 15MW first stage, measure not stated, operator's figure Operational |
| DCI SYD01 | DCI Data Centres Eastern Creek | 11 MW Operational |
| Equinix SY6 | Equinix Silverwater | 9 MW Operational |
| Dataspace Greystanes | Dataspace Pemulwuy | 7 MW Operational |
| Dataspace Homebush | Dataspace Sydney Olympic Park | 2.8 MW Operational |
| Macquarie DC IC1 | Macquarie Data Centres Haymarket | 2 MW Operational |
| 5G Networks NSDC | 5G Networks St Leonards | 1.5 MW 1.5MW power availability, operator's figure Operational |
| 5G Networks SDC | 5G Networks Pyrmont | 1.5 MW 1.5MW of power, measure not stated, operator's figure Operational |
| AWS Eastern Creek | AWS Eastern Creek | Capacity not published Operational |
| AWS Smeaton Grange | AWS Smeaton Grange | Capacity not published Operational |
| CDC EC1-EC4 | CDC Data Centres Eastern Creek | Capacity not published Operational |
| CDC EC5/EC6 | CDC Data Centres Eastern Creek | Capacity not published Operational |
| DigiCo SYD1 | DigiCo Ultimo | Capacity not published Operational |
| Equinix SY1/SY2 | Equinix Mascot | Capacity not published Operational |
| Equinix SY3 | Equinix Alexandria | Capacity not published Operational |
| Equinix SY4/SY5 | Equinix Alexandria | Capacity not published Operational |
| Keppel Gore Hill | Keppel DC Artarmon | Capacity not published Operational |
| Microsoft Kemps Creek | Microsoft Kemps Creek | Capacity not published Operational |
| Unisys Rhodes | Unisys Rhodes | Capacity not published Operational |
| Vocus SYD01 | Vocus Communications Alexandria | Capacity not published Operational |
| Vocus SYD04 | Vocus Communications Rosebery | Capacity not published Operational |
| CDC Marsden Park | CDC Data Centres Marsden Park | 504 MW Under construction |
| NEXTDC S4 | NEXTDC Horsley Park | 365 MW Under construction |
| Project Blue Tongue | Operator not named Wetherill Park | 132 MW Under construction |
| DCI SYD02 | DCI Data Centres Eastern Creek | 63 MW Under construction |
| Starwood/Doma/Telstra | Starwood/Doma/Telstra Minchinbury | 62 MW Under construction |
| Goodman SYD01 | Goodman Group Artarmon | 61 MW Under construction |
| DigiCo SYD1 expansion | DigiCo Ultimo | 52 MW 52MW expansion, measure not stated, operator's figure Under construction |
| Macquarie IC3 Super West | Macquarie Data Centres Macquarie Park | 47 MW Under construction |
| CDC Kemps Creek | CDC Data Centres Kemps Creek | 1,008 MW Planned |
| AirTrunk/ISPT Mamre Rd | AirTrunk / ISPT Kemps Creek | 1,000 MW 1GW power capacity on the NSW Planning Portal; the application's own figures run from 600MW to 1.2GW Planned |
| NEXTDC S7 (OpenAI) | NEXTDC Eastern Creek | 550 MW Planned |
| STACK SYD01 | STACK Infrastructure Erskine Park | 450 MW Total power consumption, proposal under assessment Planned |
| Goodman Project Atlas | Goodman Group Eastern Creek | 348 MW Total power consumption (500MVA supply) Planned |
| Stockland Kemps Creek | Stockland Kemps Creek | 342 MW Planned |
| Microsoft Honeman Close | Microsoft Huntingwood | 96 MW Planned |
| Goodman Project Duke | Goodman Group Mascot | 85 MW Planned |
| GreenSquareDC SYD1 Stage 2 | GreenSquareDC Norwest | 80 MW Planned |
| NEXTDC S5 | NEXTDC Macquarie Park | 80 MW Planned |
| ISPT Julius Avenue | ISPT North Ryde | 76 MW Planned |
| Digital Realty SYD12 | Digital Realty Macquarie Park | 70 MW Total power consumption, proposal Planned |
| Goodman Project Pluto | Goodman Group Guildford West | 68 MW Planned |
| AWS Gregory Hills | AWS Gregory Hills | 53 MW Planned |
| Stockland/EdgeConneX MPark | Stockland / EdgeConneX Macquarie Park | 51.4 MW Planned |
| 192 Narellan Road, Campbelltown (planned) | Operator not named Campbelltown | 100MW total load Planned |
| AIMS Bella Vista | AIMS Capital Bella Vista | Capacity not published Planned |
| Goodman Project Apollo | Goodman Group Macquarie Park | 135MW total load Planned |
| Stockland Wetherill Park | Stockland Wetherill Park | Capacity not published Planned |
Substations on this map
Figures are as each network publishes them. Networks rarely publish spare capacity, so cells without a published figure say not published.
| Substation | Network | Firm rating (N-1) | Peak demand | Network's own figure | Source |
|---|---|---|---|---|---|
| Sydney West Bulk Supply Point | Transgrid | not published | not published | 64 MW now, 0 MW in 5 years (Available capacity for load, 132 kV) | Transgrid Transmission Annual Planning Report portal, September 2026 |
| Kemps Creek Substation | Transgrid | not published | not published | not published | not published |
| Vineyard Bulk Supply Point | Transgrid | not published | not published | 130 MW now, 0 MW in 5 years (Available capacity for load, 132 kV) | Transgrid Transmission Annual Planning Report portal, September 2026 |
| Macquarie Park Zone Substation | Ausgrid | 114.32 MVA | 61.84 MVA (summer 2024/25) | not published | Ausgrid Distribution and Transmission Annual Planning Report 2025, Substation Capacity and Demand Forecast, December 2025 |
| Lane Cove Switching Station | Ausgrid | not published | not published | not published | not published |
| Mason Park Switching Station | Ausgrid | not published | not published | not published | not published |
| Alexandria Subtransmission Substation | Ausgrid | 142.9 MVA | 24.54 MVA (summer 2024/25) | not published | Ausgrid Distribution and Transmission Annual Planning Report 2025, Substation Capacity and Demand Forecast, December 2025 |
| Eastern Creek Substation | Endeavour Energy | 45 MVA | 21.52 MVA (2025) | not published | Endeavour Energy Distribution Annual Planning Report 2025 portal, December 2025 |
| Mamre Zone Substation | Endeavour Energy | 90 MVA | 65.02 MVA (2025) | not published | Endeavour Energy Distribution Annual Planning Report 2025 portal, December 2025 |
| Marsden Park Substation | Endeavour Energy | 45 MVA | 22.73 MVA (2025) | not published | Endeavour Energy Distribution Annual Planning Report 2025 portal, December 2025 |
| Huntingwood Substation | Endeavour Energy | 90 MVA | 46.22 MVA (2025) | not published | Endeavour Energy Distribution Annual Planning Report 2025 portal, December 2025 |
| Rooty Hill Zone Substation | Endeavour Energy | 45 MVA | 30.16 MVA (2025) | not published | Endeavour Energy Distribution Annual Planning Report 2025 portal, December 2025 |
| Wetherill Park Substation | Endeavour Energy | 45 MVA | 27.23 MVA (2025) | not published | Endeavour Energy Distribution Annual Planning Report 2025 portal, December 2025 |
| Arndell Park Substation | Endeavour Energy | 45 MVA | 25.53 MVA (2025) | not published | Endeavour Energy Distribution Annual Planning Report 2025 portal, December 2025 |
| Blacktown Transmission Substation | Endeavour Energy | 360 MVA | 204.15 MVA (2025) | not published | Endeavour Energy Distribution Annual Planning Report 2025 portal, December 2025 |
Changes since October 2026
- NEXTDC S5, Digital Realty SYD12, DCI SYD01, DCI SYD02 and AWS Smeaton Grange moved to their street, lot or planning record locations. Source
- Greystanes and Homebush added to the map under Dataspace, which bought them from Fujitsu. Source
- Seven pins moved to their planning record or street address locations: NEXTDC S7, STACK SYD01, AWS Gregory Hills, Project Blue Tongue, Microsoft Honeman Close, Equinix SY6 and Stockland Wetherill Park. Source
- CDC Kemps Creek added to the map: a six-building campus at 845-901 Mamre Road with about 1,008MW of IT capacity in CDC's October 2026 plan. Source
- AirTrunk/ISPT Mamre Rd, Microsoft Kemps Creek and Stockland Kemps Creek moved to their planning record locations, and Microsoft Kemps Creek now shows as operating. Source
- Goodman Project Apollo at Macquarie Park added to the map. NSW approved it on 2 September 2026 for up to 135MW of total power. Source
- Capacity figures we could not source now read "Capacity not published", and the totals count only sites with a published figure. Source
- Substation figures added as the networks publish them: firm rating and peak demand for eight Endeavour Energy and two Ausgrid substations, and Transgrid's available capacity for load at Sydney West and Vineyard. Source
About This Map
This map tracks data centres across Greater Sydney, from operating campuses to sites under construction and projects that have been announced, lodged or approved. Capacity is IT load in megawatts unless the site's entry names another measure. Figures are as the operator or the planning application states them, and sites without a published figure are marked "Capacity not published".
Records come from operator announcements and ASX releases, the NSW Planning Portal, and the planning reports published by Transgrid, Ausgrid and Endeavour Energy. Each record carries the source it came from.
The map is refreshed on the first business day of each month, and the date above the map is the date the data was last checked, not the date you opened the page.
Substation locations: NSW Spatial Services. Constraint and augmentation detail: Transgrid Western Sydney RIT-T reports 2024, Transgrid network capacity update June 2026, Ausgrid Wallumatta contingent project application 2025, NSW distributors' submission to the NSW data centres inquiry 2026.
Map researched and maintained by CertifiedStrategic.com.
Power lines and power stations: © Commonwealth of Australia (Geoscience Australia) 2026, Electricity Infrastructure, CC BY 4.0
Related Analysis
Sydney's data centre pipeline sheds four early-stage plans
Stockland plans A$5bn Kemps Creek AI data centre with EdgeConneX
Macquarie Data Centres files A$2bn Macquarie Park plan
Southern Cross Electrical wins NEXTDC S4 electrical contract
